Can remodeling project margin cover the crew and milestone cash gaps?

The reference needs 1.9212 earned-project equivalents a month for cash-after-maintenance break-even. At 2 equivalents and $28,000 each, its mature cash result is $1,126 before receivable movement. That thin result is separate from the cash needed before milestone collections: the illustrative one-project schedule has a $2,976 milestone-end cash gap even though its final allocated surplus is $563.

What you will produce: A contribution and break-even calculation tied to complete paid coverage, a crew-capacity check, and one comparable project schedule that separates earned value, customer advances, actual receipts and cash payments.

Updated October 2, 2026 · Worked examples and editable worksheets

What to have ready

Bring a measured project scope, net contract value, supplier and specialty-subcontractor quotes, complete paid carpenter time, paid management and administration, employer costs, standing expenses, compliant customer terms, earned milestones and actual payment dates.

Work through the calculation and decision

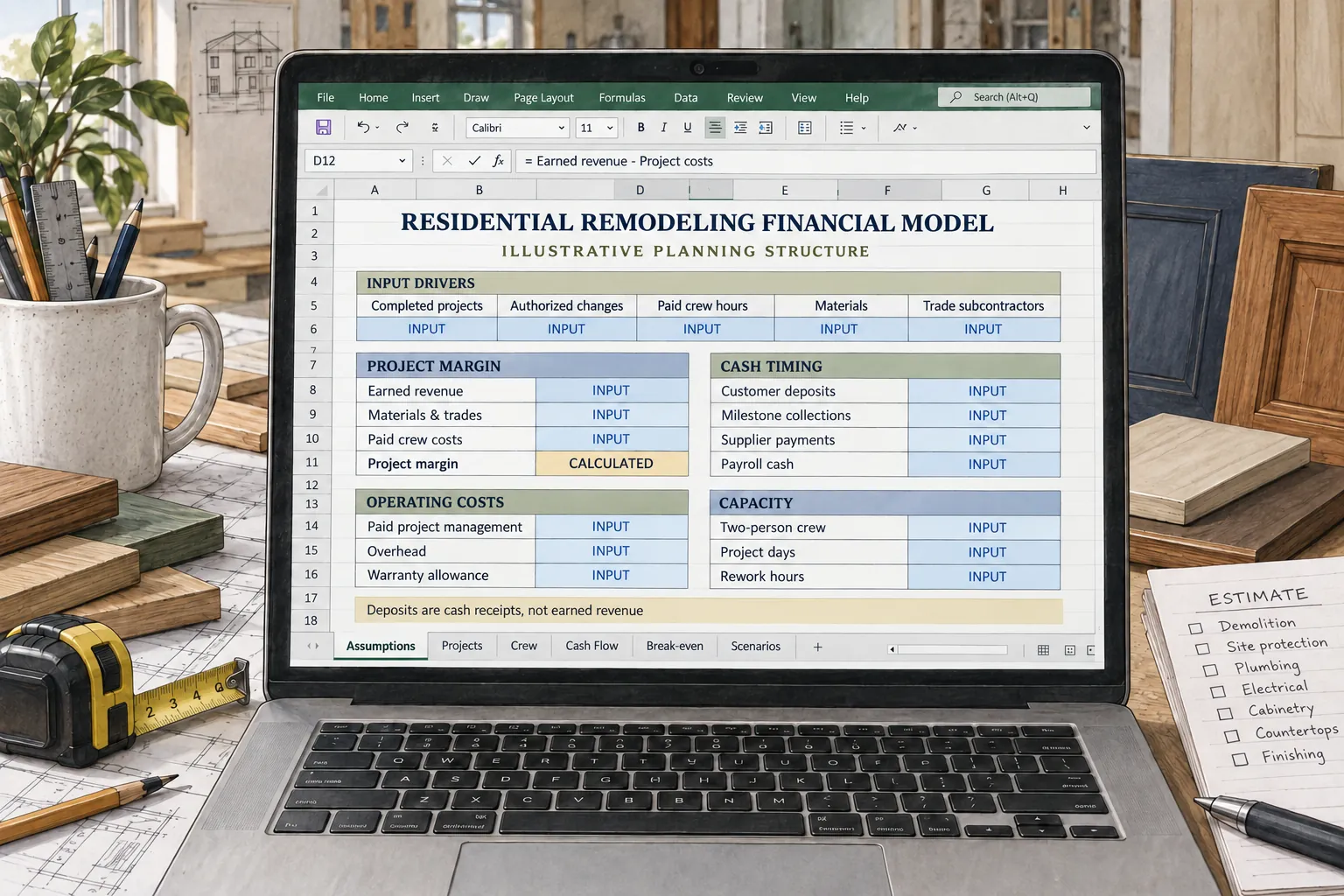

Conceptual Residential Remodeling financial workbook connecting completed projects, authorized changes, paid crew hours, materials and trade subcontractors with project margin, cash timing, paid management, overhead, warranty and two-person crew capacity; customer deposits are separate from earned revenue.

Define comparable earned scope

Choose a narrow interior project with measured quantities, selected finishes, known exclusions and authorized specialty work. The $28,000 contract value here is an authored comparable-project assumption, after agreed price adjustments and excluded unearned scope. It is not a national average, provider quote or proof of customer demand.

Count delivered value under the documented contract and accounting policy. Two earned-project equivalents mean $56,000 of accepted delivered scope; they may arise across several whole projects. Estimates, signatures, backlogs, deposits, material orders and unapproved changes do not become additional revenue.

Reconcile direct cost before claiming margin

The example assigns 30% of contract value to materials, 15% to licensed specialty subcontractors, 3% to disposal/delivery and 1% to collection costs. These authored shares total 49%, or $13,720 per equivalent, leaving $14,280 contribution before the employee roster and standing costs. Obtain actual quantities and scope-matched quotes instead of assuming a material markup establishes contribution.

Make specialist supply responsibilities explicit. If an electrical subcontract already includes fixtures, adding the same fixtures to the materials ledger duplicates cost. Conversely, a labor-only trade quote leaves required material and delivery cash to the remodeler. Employee carpentry stays in payroll and is not charged again in the 49% share.

Pay for management and nonproject work

The scenario pays two carpenters for 346.67 person-hours a month, owner construction-management replacement coverage for 86.67 hours and administration for 43.33 hours. The occupation anchors produce $15,876.47 direct wages. An assumed 18% employer addition gives $18,734.23 loaded payroll; it is a teaching allowance, not the complete employment cost for a selected service area.

Add $1,200 occupancy, $6,500 other standing costs and $1,000 maintenance investment to reach $27,434.23 monthly cash commitments. Dividing by $14,280 contribution gives 1.9212 equivalents for cash break-even. EBITDA excludes maintenance investment and depreciation; EBIT includes $916.67 depreciation instead of the maintenance payment. These boundaries must not be interchanged.

Reconcile break-even with the whole-project calendar

After 32 paid nonproject carpenter hours, 346.67 paid hours divided by the assumed 140 person-hours per earned equivalent gives an average ceiling of 2.2476. The separate management ceiling is 2.2. At the 2-equivalent reference, the full field clock uses 312 person-hours.

An average-hours result does not schedule physical projects. Map deliveries, customer selections, specialist visits, protection, inspections, handover, travel and rework in dated whole-project blocks. Changing output alone does not create more carpenter time or eliminate management work.

Separate earned milestones from customer advances

The calculator uses an authored 30/40/30 earned-value sequence for one $28,000 project: $8,400, $11,200 and $8,400. Those fractions describe value accepted as delivered, not an arbitrary entitlement to collect before work. Actual contracts, applicable rules and the accounting policy determine earning and invoicing.

The default customer advance is zero. If lawful terms support an advance, record a customer obligation and apply that advance against the earliest earned invoices in this exercise. Total receipts still reconcile to $28,000; the advance never adds to project revenue. Confirm jurisdiction limits, cancellation rights, refund duties and any required handling of customer funds before entering it.

Allocate the paid commitment once

For this teaching exercise only, divide the complete monthly cash commitment by the entered monthly earned equivalent count. At 2 equivalents that allocates $13,717.12 to one equivalent, spread evenly across three milestones. The allocation covers all entered paid coverage and standing cash; it is not an observed job-cost rate or a second payroll charge.

Project direct cash follows the assumed 50/40/10 sequence. The first stage pays $6,720 of materials/specialist/disposal cash, $4,572.37 allocated commitments and $84 collections cost against an $8,400 receipt. Its interval-end balance is negative $2,976.37. The project ends with $562.88 after all allocated costs; a positive ending balance does not erase that earlier funding gap.

Stress collection and labor separately

The delay control shifts each nonadvance receipt by one illustrative milestone interval while retaining earned value and the cost schedule. It does not introduce another month of overhead or represent a real calendar duration. The resulting gap is a timing sensitivity; a real delay can also add supervision, idle wages, storage, hire charges and further cash costs.

Increase employer costs, carpenter person-hours, direct scope or collection delay separately, then combine justified cases. At 1.6 earned equivalents, a 20% volume reduction with other monthly inputs fixed produces a $4,586 cash-after-maintenance loss. The June 2026 BLS small goods-producing employer comparison reports $11.95 benefits per $30.99 wages, about 38.56% of wages. Applying that broad comparison only as a sensitivity also reverses the default positive cash result; it is not a quoted benefit package for a remodeler. Do not assume the narrow surplus can absorb hidden scope, a larger employer bill and delayed collection together.

Replace interval balances with payment dates before committing

This exercise calculates milestone-end cash. Within an interval, an early supplier payment can create a deeper trough than the displayed balance. Before accepting a contract, replace interval totals with dated purchase orders, wages, specialist payments, lawful advances, invoice acceptance and cash settlement.

Keep tax, restricted funds, retainage, refunds, debt, startup payments and owner distributions in separate schedules. The national 60-month reference additionally includes a 15-day receivable assumption and an opening ramp; the project exercise does not replace that broader opening-funding model.

Two earned equivalents and one project cash sequence

Authored illustration · not a market estimate

Wage anchors are observed national occupation medians. Project values, cost shares, time, overhead, milestone percentages and payment timing are authored teaching assumptions.

Two earned equivalents and one project cash sequence
Input or resultReferenceWhat it establishes
Earned value per equivalent$28,000Assumed comparable interior scope
Mature earned throughput2 equivalents/monthAssumed accepted delivered value, not signed projects
Contribution before roster$14,280/equivalentDerived after 49% direct and collection costs
Loaded paid roster$18,734/monthOccupation medians plus assumed 18% additions
Cash after maintenance$1,126/monthBefore receivable movement, financing and taxes
Exact cash break-even1.9212 equivalents/monthDerived from the same costs and contribution
Lower capacity ceiling2.2 equivalents/monthAssumed management cap below average field-hour limit
One-project final allocated surplus$563Separate teaching allocation; not owner take-home
Largest displayed milestone-end gap$2,976Dated and within-stage cash requirements can be greater

What this changes: A narrow earned margin requires supported cost, scope and payroll; a collectible milestone schedule still needs cash before its lowest balance.

Test earned remodeling margin, paid crew capacity and milestone cash

Start with the illustrative example, then replace its inputs with your own assumptions. All money amounts are in USD. The result updates in this tab.

Illustrative result · assumptions apply

Contribution per earned-project equivalent before paid roster
$14,280.00
Loaded monthly paid roster
$18,734.23
Monthly earned revenue
$56,000.00
Monthly EBITDA
$2,125.77
Monthly cash after maintenance before receivable movement
$1,125.77
Monthly EBIT
$1,209.10
Exact EBITDA break-even
1.85 equivalents/month
Exact cash-after-maintenance break-even
1.92 equivalents/month
Exact depreciation-inclusive EBIT break-even
1.92 equivalents/month
Field-hour average ceiling
2.25 equivalents/month
Lower field and management ceiling
2.2 equivalents/month
Field hours used including nonproject work
312 hours
Allocated paid roster and standing cash per equivalent
$13,717.12
One-project surplus after allocated cash commitments
$562.88
Largest modeled milestone-end cash gap before extra funding
$2,976.37
Customer advance; creates a service obligation
$0.00

Cash break-even fits the entered average capacity. Earned-project equivalents measure comparable delivered value, not fractional physical jobs. The one-project schedule allocates all entered paid coverage and standing cash once; it assumes 30/40/30 earned milestones and 50/40/10 direct-cost payments. It measures interval-end balances, so cash needed within an interval can be greater. Intervals are not weeks or a dated financing forecast. Advances require lawful terms and are applied against later earned invoices. Taxes, financing, restricted funds, retainage and owner distributions need separate schedules.

One comparable project: earned value and cash by milestone (USD)
StageEarned valueAdvance applied to invoiceCash receivedDirect project cashAllocated paid coverage and standing cashCollection costCumulative project cash
Advance, before work$0.00$0.00$0.00$0.00$0.00$0.00$0.00
Milestone 1$8,400.00$0.00$8,400.00$6,720.00$4,572.37$84.00-$2,976.37
Milestone 2$11,200.00$0.00$11,200.00$5,376.00$4,572.37$112.00-$1,836.74
Milestone 3$8,400.00$0.00$8,400.00$1,344.00$4,572.37$84.00$562.88
Delayed settlement$0.00$0.00$0.00$0.00$0.00$0.00$562.88

Complete your decision record

A contribution and break-even calculation tied to complete paid coverage, a crew-capacity check, and one comparable project schedule that separates earned value, customer advances, actual receipts and cash payments. Enter the finding or number, the source and the next action for each row. “Supported” records your assessment of that item; it does not approve the business or certify completed research.

Working record for your business
Item and what to recordYour finding and evidenceStatus and next action
Comparable scope and earning policyMeasured quantities, agreed value, exclusions, delivered acceptance and revenue policy
Direct costWho supplies each item; material, trade, disposal, delivery and collection amounts
Paid coverage and capacityCarpenter person-hours including rework, nonproject work, management, administration and actual employer additions
Milestone and advance termsApplicable jurisdiction, lawful advance, delivered value, acceptance, invoice and advance application
Dated cash and cost to completePurchase, trade and wage dates; cash settlement; retainage; unperformed obligations; available unrestricted funding

5 items have no evidence recorded yet.

Entries are temporary and are not sent to us or saved automatically. Download your completed work before leaving or refreshing this page.

Choose your next action

Use the finding to change the plan
If your finding is…Your next action
Contribution cannot fund the paid calendarRequote supported scope or reduce commitments before accepting another project.
Cash break-even exceeds the field/management ceilingChange price, measured productivity, scope or the roster together; extra cash does not create delivery capacity.
The project ends positive but goes negative earlierArrange dated unrestricted funding or lawful matched payment terms before supplier and payroll commitments.
Additional employer costs or hidden scope reverse the resultReplace the assumed allowance with actual costs and recalculate; do not treat the default surplus as a reserve.

Errors that can change the result

  • Treating a signature, advance or purchased material as earned revenue.
  • Counting specialist materials twice or adding employee labor again to the direct-cost share.
  • Removing owner management and administration to make a bid appear profitable.
  • Using equivalent averages as a physical schedule or a statewide demand forecast.
  • Treating displayed milestone-end cash as the deepest possible daily cash gap.
  • Assuming the calculator advance setting establishes lawful or unrestricted customer funds.

Apply this to your business

These operating formats match the decisions in this guide.

Apply the result to the Residential Remodeling Company plan

Carry the earned-scope unit, full paid roster, capacity and collection timing into the national plan and the selected state reference. Values entered here are not automatically transferred to another calculator.

Continue with the next part of your plan

Sources and limits

The sources below provide the stated background. The worked examples, calculator defaults and decision exercises are authored teaching material. They do not establish market prices, local demand, legal applicability or completed state research.

Source pages checked October 2, 2026. Research and review standards · Report an issue

Editorial assessment

Use the thin margin and early cash gap to choose the next test

Interpretation of an authored planning exercise

The default earns a narrow surplus after its complete paid roster and standing cash commitment. Its positive final allocated project result can still require funding before the first milestone settles; the displayed milestone-end gap is a bounded teaching calculation, not the deepest possible dated cash trough.

The next useful evidence is one scope-matched bid, complete employee and specialty-trade workload, actual employer additions and payment dates. Reconsider the commitment if cost, hours or earning rate reverse contribution, or if unrestricted funding cannot support supplier and wage payments before lawful collections.
